Raymond Community Park

Location: 2101 E. First St.

This community park property is currently under construction. View the Raymond Community Park Phase 1 Design Project (PDF) and the video update.

Although the official park opening is still in the planning stages, the tennis and pickleball courts are now open for a sneak preview!  Courts are available on a first-come, first-served basis with the following limitations and requirements.

TO PARK:  Please enter from the westmost entrance on First Street (not from the Construction Entrance near Coit Road).

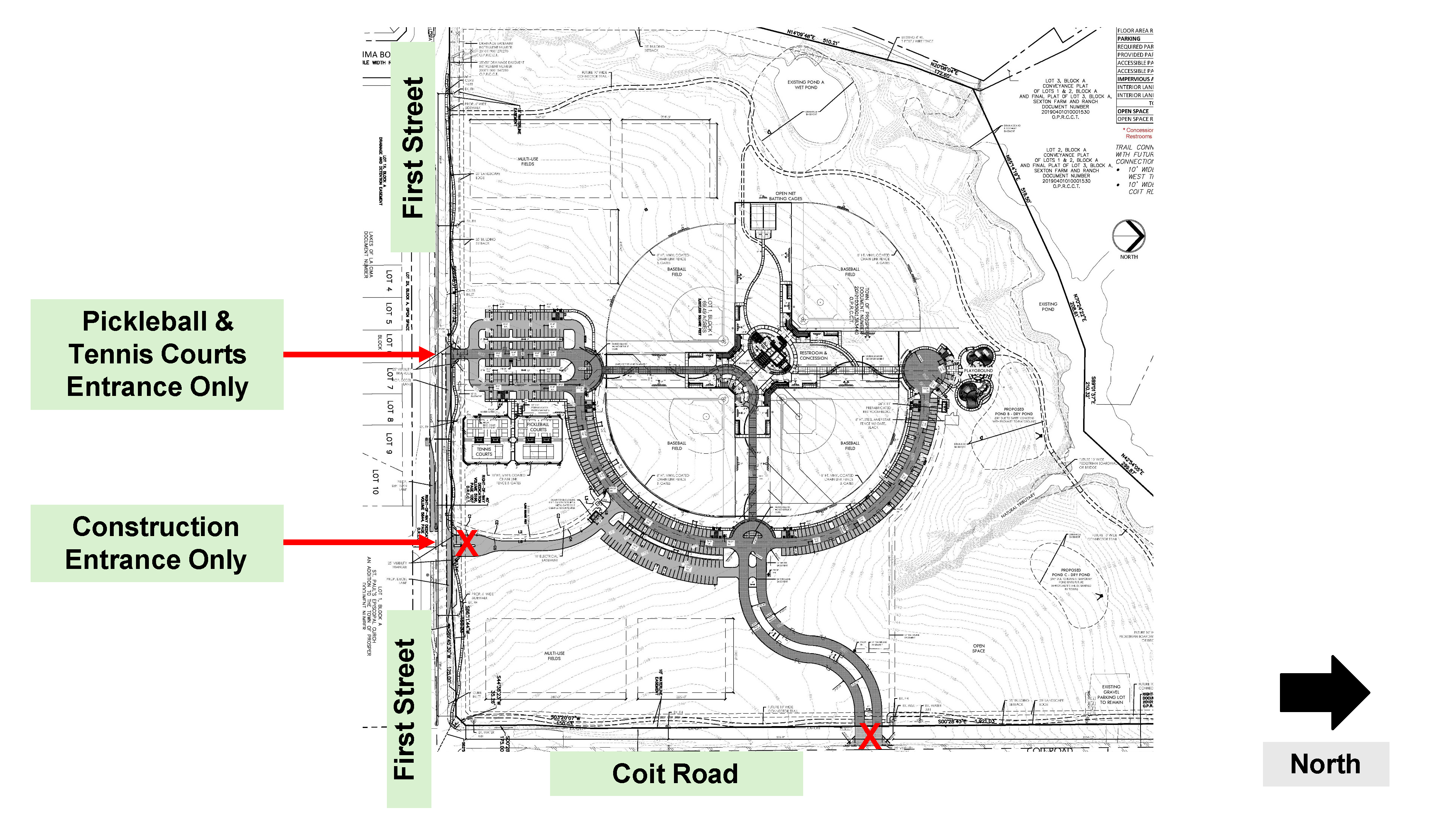

map to parking

  • Courts are open DAYLIGHT HOURS only (no lights).
  • The adjacent restroom is not yet open, but a portable facility will be placed on site soon.
  • Parking is available in the adjacent lot west of the courts only.
  • The park remains under construction. Please use caution and excuse our mess!
  • All fields and the park playground are closed and access is not allowed.

Planned amenities:

  • Sports complex with pickleball courts
  • Playground
  • Demonstration garden
  • Parking
  • Restrooms
  • Landscaping and irrigation
  • Raymond Community Park Demonstration Garden:  Plants chosen will have the ability to withstand heat, drought and cold conditions of the North Texas climate.  The garden will include raised beds planted with a wide variety of drought tolerant and well-adapted flowering plants and herbs. Refer to the info sheet, The Importance of Native Plants for a preview of the garden!

For additional project updates, please visit the CIP Dashboard for Raymond Community Park Phase 1.

Park Updates


January 2026

  • The concrete pours for the trail are underway. Overall, the trail is now at 100% completion.
  • Electrical work is nearing full completion.
  • All concrete pours for the overall park are now 100% complete.
  • The tennis and pickleball courts are 100%.
  • Sod installation is expected to start in mid-January and be complete in mid-February.
  • Main restroom/concession building is at 95% completion.
  • Overall project substantial completion is scheduled for late February 2026.
